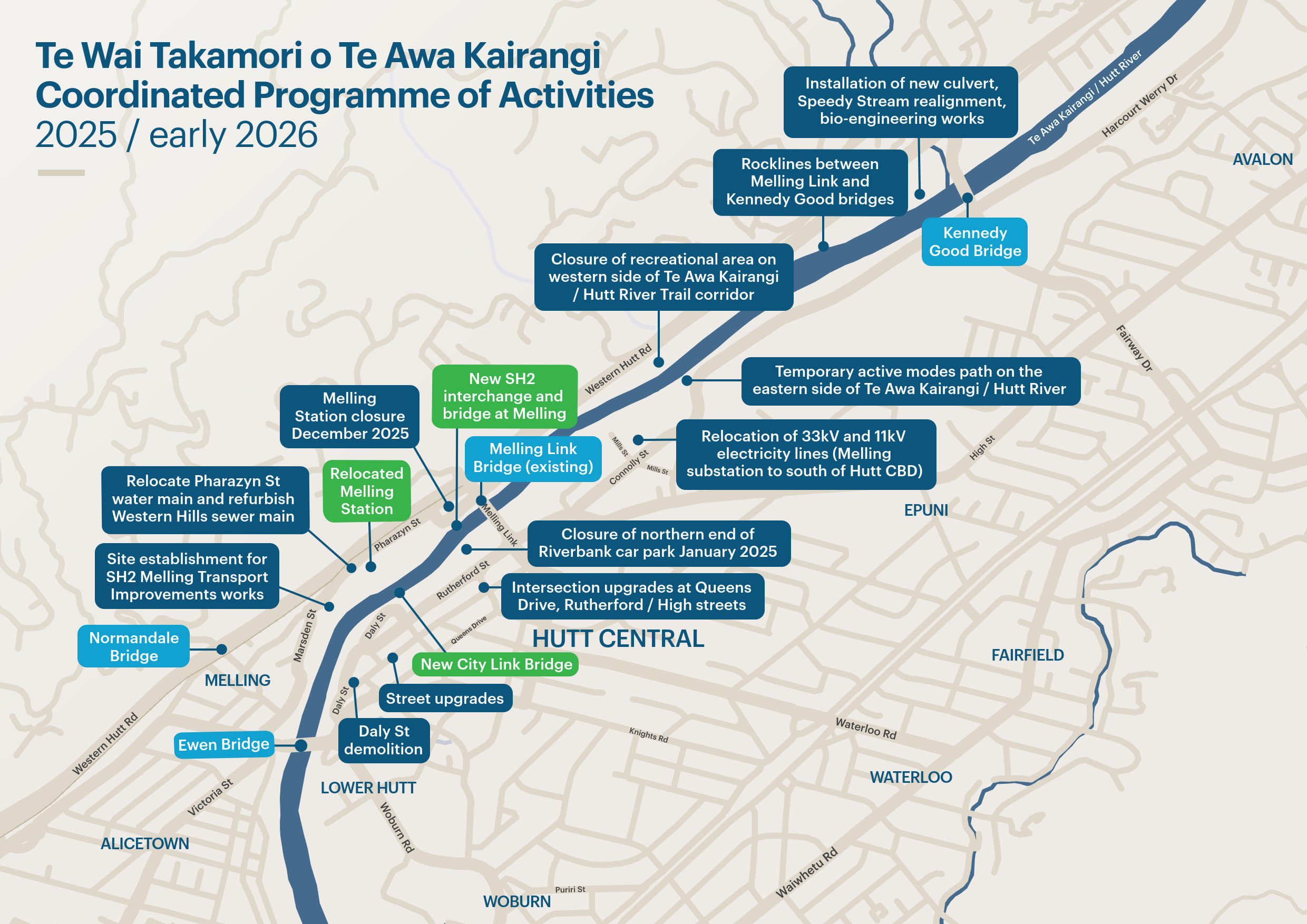

Take a look at what's coming up on our schedule. It includes work being completed by Greater Wellington, Hutt City Council and NZ Transport Agency Waka Kotahi (NZTA) as part of Te Wai Takamori o Te Awa Kairangi.

There will be significant changes in Lower Hutt over the coming years as a large programme of construction begins on both sides of Te Awa Kairangi / Hutt River. This construction will have an impact on how people move around the city, and it will vary over time as construction starts and finishes in different areas.

The table and map below highlight what work is happening in the coming years, where it is, who is carrying out the work and the disruption you’re likely to experience.

We’re committed to minimising the impact of construction across all parts of Te Wai Takamori o Te Awa Kairangi. But it’s important to remember that large infrastructure projects, such as this, are complex and disruption will be inevitable. While these disruptions will be inconvenient at times, this project will bring long-term benefits to the community.

Last updated: Wednesday 10 June 2026

Who is leading the work

What's happening

Where

When

What this means for you

Greater Wellington

Building rock lines to strengthen the river's edge

On both sides of Te Awa Kairangi / Hutt River between Melling and Kennedy Good bridges

Ongoing

Some small sections of the Hutt River Trail may be diverted. 

Heavy machinery working in the river and on the river’s edge.

Greater Wellington

Underground demolition

Marsden Street

Ongoing

Heavy machinery at site Monday - Saturday. 

Some noise and possible vibration.

No change to traffic routes.

Greater Wellington

Demolition

4 - 5 Daly Street and 69 - 95 High Street

March - August 2026

Heavy machinery at site Monday - Saturday

Greater Wellington

Removing willows On both sides of Te Awa Kairangi, between Kennedy Good and Ewen Bridges  July - December 2026

No impact on vehicles.

Some areas adjacent to the river may be closed to the public while tree-felling takes place.


Greater Wellington

Extracting gravel and alignment works Inside the river corridor July - December 2026 Heavy machinery working inside the river corridor. In these areas, direct access to the water’s edge will be restricted.

Wellington Electricity for Greater Wellington

Relocation of 33kV & 11kV electricity lines begins  Starting at Melling Substation, heading south to Marsden Street Ongoing Expect traffic management and restricted access to the riverbank and shared path areas.

NZTA (Melling Transport Improvements)

Closure of western side of Te Awa Kairangi / Hutt River corridor for site establishment for Melling Link Bridge and SH2 works  River corridor area between Block Rd and approx. 800m south of Belmont School  Ongoing All users including walkers and cyclists will need to use a temporary path on the eastern side of Te Awa Kairangi / Hutt River.

NZTA (Melling Transport Improvements)

Closure of western side of Te Awa Kairangi / Hutt River corridor for site establishment for Melling Link Bridge and SH2 works  River corridor area approx. 500m south of Melling Link Bridge  Ongoing Path users will be diverted to nearby street footpaths (Pharazyn St, Marsden St and Block Road), or the eastern side of Te Awa Kairangi / Hutt River.

Metlink / Greater Wellington / NZTA (Melling Transport Improvements)

Melling Station is closed.

Melling Line services terminate at Western Hutt Station

Work to remove overhead lines and railway infrastructure is in progress.

Melling Station and line between Melling Station and Normandale Bridge  Ongoing

Melling Station is closed and people are finding alternative ways to travel.

More bike parks are available at Waterloo and Petone Stations. We've boosted the number of Park & Ride facilities at Petone Station.

NZTA (Melling Transport Improvements)

Intersection upgrades

Queens Drive / High Street

Ongoing – for 2026

The intersection is closed to traffic. Pedestrians can move through it using the footpath on the McDonalds side.



NZTA (Melling Transport Improvements)

Closure of the eastern side of Te Awa Kairangi / Hutt River corridor

North of the Riverbank Car Park to Melling Bridge

Ongoing

A section of the shared path from Riverbank car park to the Melling Link Bridge underpass is closed.



We've opened a temporary cycle path on Rutherford Street – starting from the pedestrian crossing near Woolworths to the Melling Link Bridge pathway and underpass.

Hutt City Council

Design and build contract awarded for City Link Bridge

/

November 2026

Expect public consultation from early to mid-2027.

Hutt City Council

Streetscape concept design complete

/

November 2026

/

Hutt City Council

Riverside Park & Carpark concept design completed

/

November 2026

/

NZTA (Melling Transport Improvements)

Queens Drive / High Street intersection upgrade complete

Queens Drive / High Street

December 2026

Intersection reopened with all new underground services, traffic lights, upgraded footpaths, road surface and lighting

NZTA (Melling Transport Improvements)

Large stormwater pipe installation

SH2 at Tirohanga

Late December 2026 – early January 2027

Southbound closure of SH2 between Kennedy Good and Melling for two weeks; diversions in place

NZTA (Melling Transport Improvements)

Rutherford Street closure

Rutherford Street at Queens Drive

Mid-January 2027 to October 2028

Traffic diverted via reopened High Street; expect delays while change beds in

Hutt City Council

Riverbank carpark closure

/

January 2027

Alternative parking options will be available when the carpark closes

Hutt City Council

Riverbank Market relocation

Dowse Square and surrounding Civic Precinct

January 2027

A new vibrant location for people to enjoy

Hutt City Council

Construction begins on City Link Bridge

On both sides of Te Awa Kairangi / Hutt River, between Margaret St and new Melling Station

From mid-2027
